Making the right electrical infrastructure decision can save you thousands. Learn when three-phase is essential and when single-phase with smart management is enough.

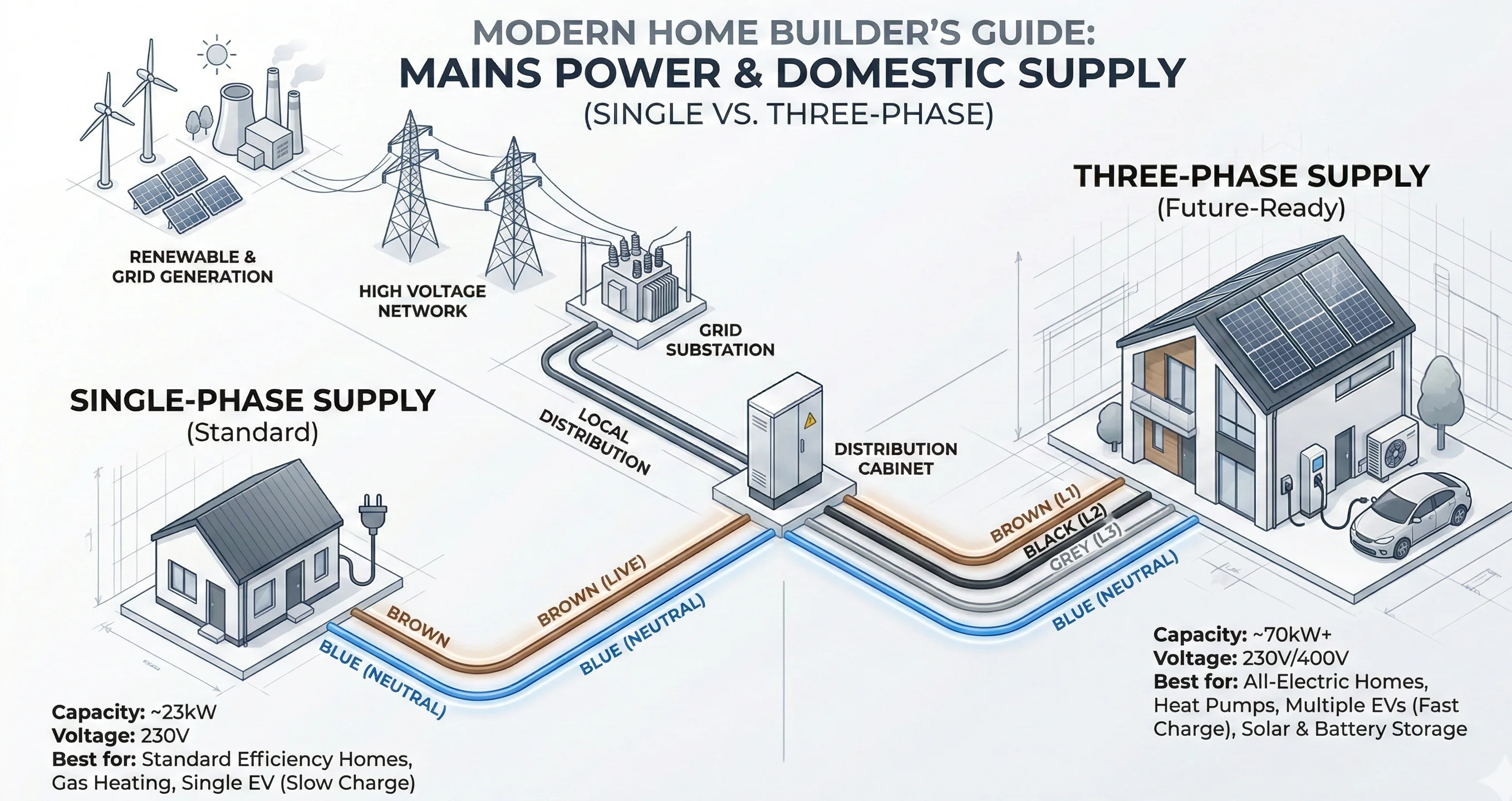

Think of your home's electrical supply like a road system. Single-phase power is like a country lane – perfectly adequate for light traffic, but it quickly becomes congested when multiple heavy vehicles try to use it simultaneously.
Three-phase power, on the other hand, is like a three-lane motorway. Each lane (phase) can carry its own load independently, giving you far more capacity and flexibility. When your heat pump, EV charger, and induction hob all fire up at the same time, a three-phase system handles it without breaking a sweat.
With new building regulations coming into force and the government's heat pump rollout accelerating, DNOs (Distribution Network Operators) are experiencing unprecedented demand for three-phase upgrades.
In 2024, average lead times for a three-phase upgrade were 8-12 weeks. By late 2025, we're seeing quotes stretching to 16-20 weeks in some regions. If you're building or renovating in 2026-2027, factor this into your project timeline.
Don't wait until your electrician requests the upgrade. Apply for your three-phase connection as soon as planning permission is secured. The DNO application process runs parallel to your build timeline, not within it.
Select all appliances you plan to run simultaneously at peak times
Three-phase upgrade costs vary wildly depending on your location and existing infrastructure. Here's what to budget for:
| Scenario | Description | Typical Cost |
|---|---|---|
| Budget Install | Three-phase already at property boundary | £800 - £1,500 |
| Standard Install | Supply within 20m of boundary | £2,500 - £4,500 |
| Complex Install | New transformer or cable run over 50m | £8,000 - £15,000+ |
Download our professionally vetted 2026 DNO application template. Using this technical language reduces the risk of rejection and speeds up your quote process.
Integravolt Tip:
Don't just ask for "more power." Ask for "60kVA Three-Phase with G100 Load Management." It tells the DNO you won't blow their local transformer.
Subject: Request for Three-Phase Supply Upgrade - [Your Property Address] Dear Distribution Network Operator, I am writing to request a formal quotation for upgrading the electrical supply to my property at [Your Full Address, Postcode]. REQUESTED SUPPLY SPECIFICATION: - Three-phase 400V supply - 60kVA total capacity (20kVA per phase) - G100 load management system integration - Smart meter compatible infrastructure INSTALLATION PURPOSE: The upgrade is required to support the following registered electrical installations: - EV charging infrastructure (22kW three-phase wallbox) - Heat pump system (suitable for property heating demand) - Solar PV array with battery storage system - Standard domestic load TECHNICAL COMPLIANCE: All electrical work will be carried out by a registered Part P electrician in accordance with BS 7671:2018+A2:2022 (18th Edition Wiring Regulations). The installation will include: - Type B RCD protection - PEN fault protection device - Appropriate overcurrent protection per circuit - Load management system to prevent phase imbalance SITE INFORMATION: - Property Type: [Detached/Semi-detached/Terraced] - Current Supply: [Single-phase 100A / Other] - Distance to nearest transformer: [Approximate distance if known] - Parking/Access: [Available for DNO vehicles] Please provide: 1. Formal quotation for the supply upgrade 2. Estimated timeline for completion 3. Any additional infrastructure requirements 4. Confirmation of local network capacity I am available for a site survey at your earliest convenience. Please contact me via [Phone Number] or [Email Address]. Thank you for your attention to this matter. Yours faithfully, [Your Name] [Date]
Remember to replace [bracketed fields] with your specific information before submission
Profile: 120m² new build, single EV, 6kW heat pump, standard cooking
Recommendation: Single-phase is adequate
Profile: 250m² new build, two EVs, 12kW heat pump, 10kW solar + battery
Recommendation: Three-phase is essential
Don't be swayed by industry fear-mongering that "everyone needs three-phase now." The truth is more nuanced:
Not sure whether you need three-phase? Download our comprehensive guide or book a technical consultation with our team.
Ensure your 3-phase infrastructure meets Part L and SAP 10.2 requirements.
View ServicesLearn how to integrate smart load management with your electrical infrastructure.
Read ArticleUnderstanding the electrical demands of modern heat pump systems.
Read Article
